Planning & Scheduling Professional (PSP) Exam Questions and Answers

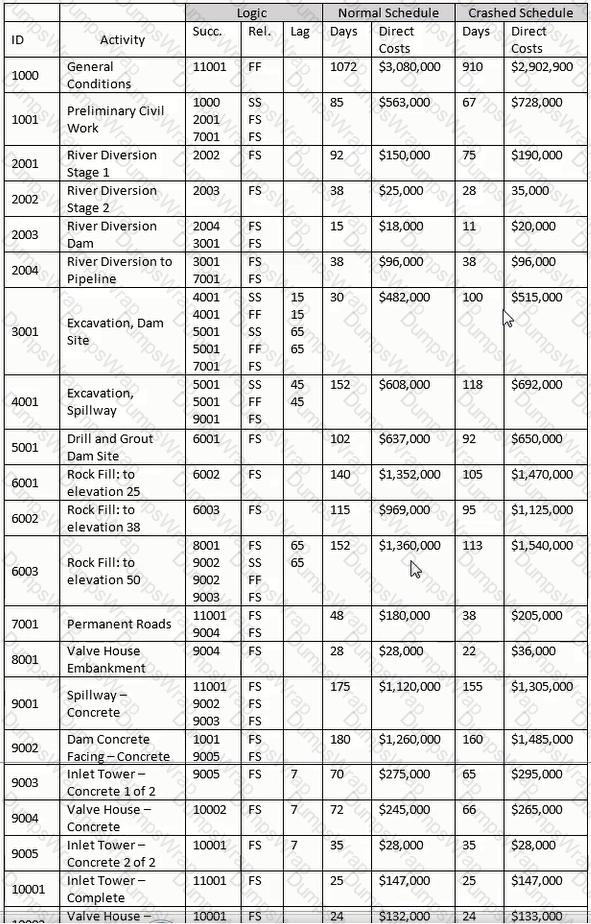

Using the normal schedule, what is the owner's total cost of the project?
Which of the following parties is NOT a stakeholder of the Spring Highway project?
The primary determination of schedule detail is:

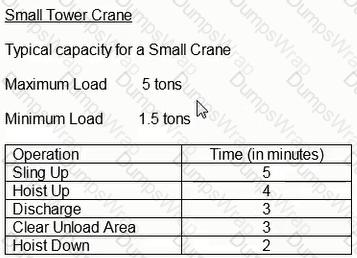

The congested site only has room for 3 cranes to operate concurrently. Only 1.75 cubic yard ICY] or1.34 cubic meter [CM] concrete buckets are available. Each crane can perform up to 35 lifts per day. Assuming a total of 30 lifts per crane pet day. what is the maximum volume of concrete that could be placed using 3 small tower cranes over a 5-day period?
Which of the following is NOT required when performing weekly or monthly schedule updates?
Select the most appropriate explanation for use of a winter/wet weather seasonal calendar for use in this project?
If Activity A was delayed 5 days from starting, which of the following adjustments will NOT maintain the completion date of Activity C at Day 40?
NO: 98
The activity with the most total float is:

The characteristic of the precedence diagramming method that models construction projects differently than the arrow diagramming method is that it____________.
Should you verify the as-built schedule before proceeding with a schedule analysis?
An early start constraint dictates
If a new hammock activity covering activities 6001 through 6003 is developed, what are governing predecessor and successor activities?
When are project planning and scheduling specifications established?
Using a 1.75 cubic yard [1.34 cubic meter] bucket, how many lifts does it take to pour each 2.000-cubic foot [56.64 cubic meter] column?

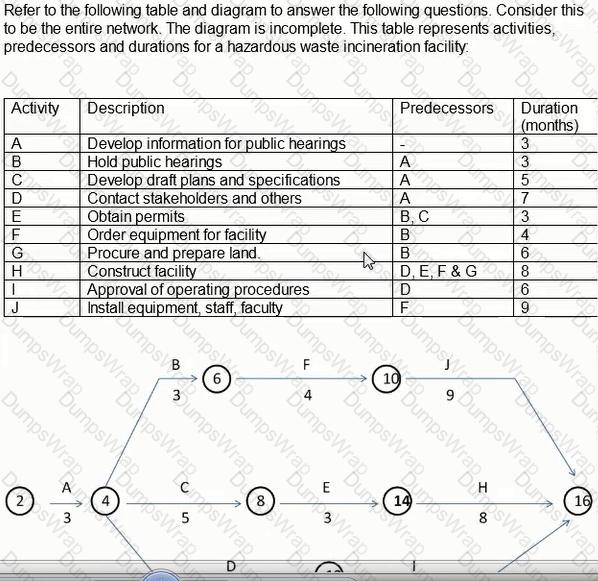

Based on the available scope information and required accuracy, different cost estimated models or methodologies are utilized Which of the following statements is NOT true?
Value engineering is:
The Cost Estimate is NOT developed to:
Which activity is drawn in the incorrect position?

Assuming that you had only one crane capable of 30 lifts per day, 3 column pours requiring 28 lifts each, plus associated assorted work requiring an additional 150 lifts, what is the minimum planned working duration for this work?

Which of the following procedures is generally recognized as acceptable when updating a schedule?
A KPI is an acronym for:
Scenario: You are providing construction management services for a small office building project. Your duties include reviewing and approving the contractor's baseline schedule. The contractor has submitted the first baseline schedule for the project.
The contractor subsequently submits a CPM schedule for its baseline schedule submittal. As part of your review, you look at the durations for each activity in the schedule. How do you determine if a duration of 10 work days for drywall installation is accurate?
SUBCO is a potential concrete bridge contractor based in a metropolitan area 300 miles away from your project. They have offered to supply manpower and equipment t BILCO at a per diem rate of $3,000 above their direct labor and equipment rates. In doing a cost benefit analysis, which of the following is NOT a consideration?
In the "normal" schedule, excluding Activity 1000, what activity(s) are concurrent with Activity 3001?

A good change management plan___________.
You are developing a detailed critical path schedule for a proposed petrochemical plant. The schedule will become a part of the project baseline document, which will be sent to the company's board of directors for its consideration. What document or resource is likely to be MOST valuable in determining the schedule's work activity durations?
: 20
Constraints control events or activities that __________________.
If a detailed estimate is NOT available to assist in the formulation of activity durations but unit quantities have been identified, what information can be utilized to estimate work package/activity durations?
Which of the following are NOT considerations or constraints of the planning process for construction scheduling?
Before the work begins, the contractor considers crashing the schedule. How much would the crashed general conditions have to be reduced to break even with the normal cost budget?

Schedule forecasts are periodically conducted to project the project schedule performance at completion Which of the following situations would probably result in an incorrect forecast?
How much Total Float does drafting the product manual have?

How could the structural steel drawing delay have been prevented?
The schedule or budget at completion less the estimate at completion is___________.
Using the crashed schedule, if you start Activity 2002 on 12 August 2021. what is the finish date for Activity 2002?
Which of the following risks CANNOT be estimated by BILCO with only a resource-loaded schedule?

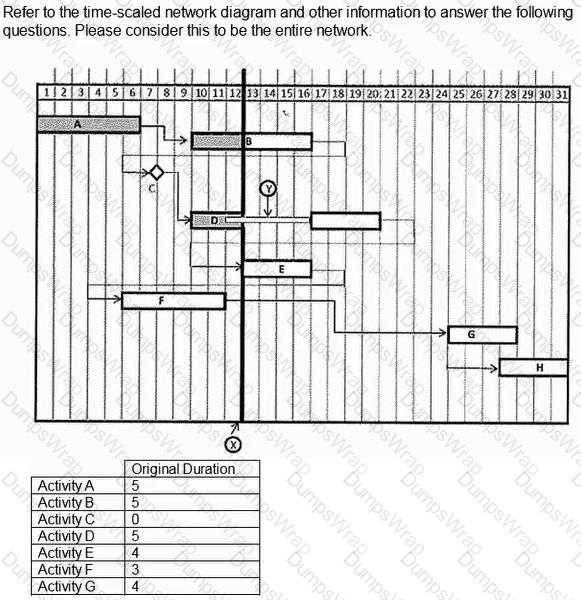

What was the original planned duration for Activity A through Activity G?

When using a detailed estimate as the basis for work package/activity durations, which element does NOT need to be identified before the activity durations can be calculated?
For activity 11001. why would the crashed direct cost be greater than the direct cost of the normal schedule?
Which of the following are NOT normally included in the project scope statement, either directly or by reference?
Why does activity 11001 not show successor activities?

Under which circumstance should one perform resource-leveling calculations?
When project risk is reflected in scheduled activities, what is the most significant characteristic of those activities?

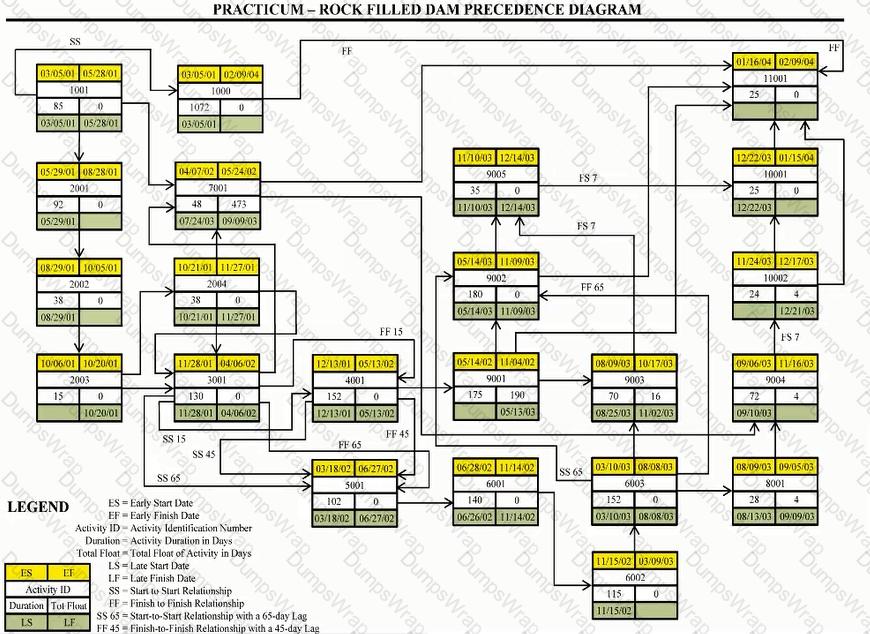

Determine the correct formula and date for the late start for Activity 9001.

Determine the correct formula and date for the late finish for Activity 2001.

Using the "normal" schedule, given Activity 3001 and the relationship with Activity 4001, what is indicated?

Using the normal schedule, what is the early finish date and total float of Activity 10002?
The project goals_________.
If someone wanted to constrain a project's end date so that any project slippage would cause negative float, they would do so by using
Why does activity 1001 have two successor activities?

Schedule Risk may affect the following:
Which of these letters, symbols or words best approximates the graphical shape of a project's cumulative BCWS?
Which of the following will NOT affect the total float calculation of a non-resource leveled schedule?
At a minimum, periodic reporting must be done at what interval?

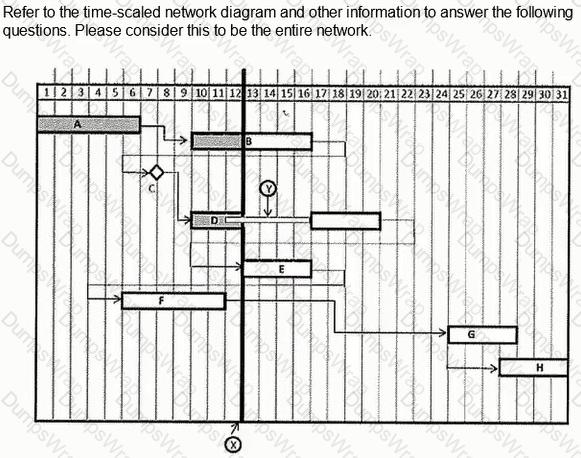

What does the heavy, vertical line at "X" represent?

The best source of project risk or opportunities is:
Project Life Cycle Phases do NOT include the following item:
Each column must be poured in one day. Each column requires 2,000 cubic feet of concrete. The lift bucket has a capacity of 40 cubic feet. How many lifts will be required per column pour?

Free float is the
If a cost estimate assumes that 240 hours will be expended on a given activity, and the projected crew size expected to perform that activity is 5 personnel working and 8-hour workday, what is the calculated duration for the activity?
Using the "normal" schedule, if you start Activity 7001 on April 1, 2002, and using a 5-day workweek, what the finish date for Activity 7001?

In the normal schedule, excluding Activity 1000. what activity(s) are concurrent with Activity 3001?
What method would be the best way to determine the most likely as-built critical path of a project that is underway, and the schedule of which has been partially progressed?
At the end of month one, did the delay to the parking structure foundation delay the project?
